This article explains what makes land suitable for modular construction, walks through common restrictions, and provides clear steps to evaluate any property before you commit financially.
You’ll learn about zoning laws, utility requirements, and costs that affect where you can place a modular home.
No, you cannot put a modular home on any land and there are multiple factors which determine suitability:
Each factor can block or delay your project regardless of land ownership.

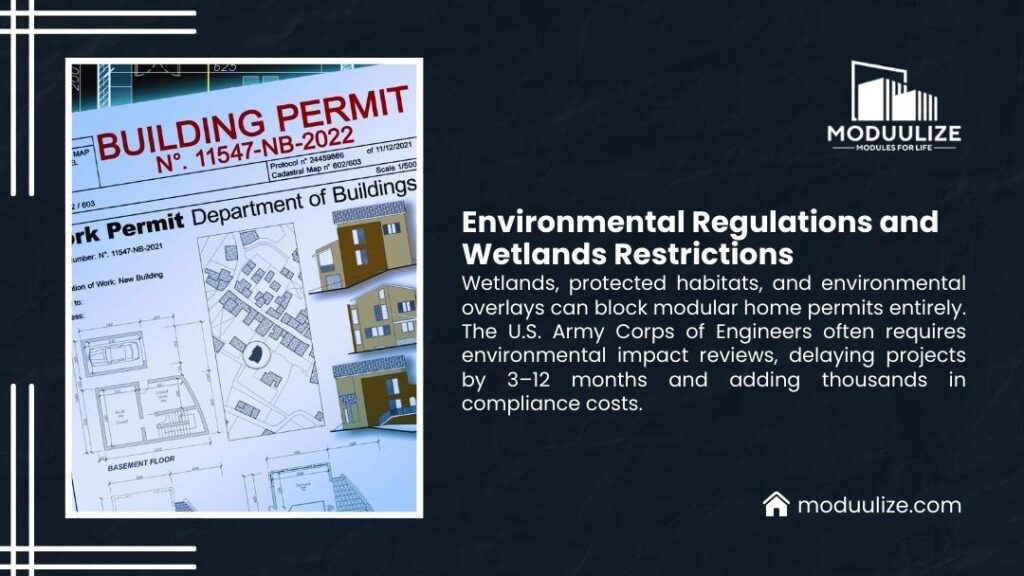

The confusion stems from a common assumption that property rights include absolute building freedom. In reality, local governments control what gets built and where through zoning classifications and permit requirements.
Zoning classification Determines if residential use allowed High
Building codes Sets construction standards and permits High
Utility access Affects feasibility and budget Medium
Soil conditions Influences foundation type and cost Medium
Road access Controls transport and delivery Medium
HOA restrictions Can block modular homes entirely High
Modular homes meet the same building codes as site-built construction. They require permanent foundations, proper permits, and compliance with all local regulations. The factory construction method doesn’t exempt you from any requirement that applies to traditional homes.
Your first step involves research, not purchase. Check zoning maps, call the planning department, review deed restrictions, and assess utilities before you sign any contract.
Land suitability depends on regulatory approval, physical characteristics, and infrastructure availability. Each element creates constraints that limit or enable construction.
Every parcel falls under a specific zoning classification that dictates allowed uses. Residential zones typically permit modular homes, but industrial or agricultural zones may not.
According to research from the Bipartisan Policy Center, 57% of jurisdictions across 32 states require lot sizes larger than half an acre for factory-built housing. These minimum lot requirements significantly impact affordability and placement options.
Zoning regulations control more than just land use. They also govern setbacks from property lines, building height limits, lot coverage ratios, and architectural requirements like roof pitch or exterior materials.
Zoning Type Typical Modular Allowance Common Restrictions
R-1 Single Family Usually permitted Minimum square footage rules
R-2 Multi Family Permitted with conditions Density limits apply
Agricultural Varies by jurisdiction May require 5-10 acre minimums
Rural Residential Generally permitted Road frontage requirements
Commercial Not permitted Residential use prohibited
Some municipalities maintain outdated distinctions between modular and manufactured homes. Modular construction follows state and local building codes identical to site-built homes, while manufactured homes follow HUD federal standards.
If local ordinances restrict “mobile homes” or “manufactured housing,” verify whether the language specifically excludes modular construction. Many deed restrictions use imprecise terminology that doesn’t apply to modern modular homes.
Every home needs water, sewer, electricity, and often natural gas. The cost to establish these connections varies dramatically based on distance from existing infrastructure.
Public utilities simplify the process. Municipal water and sewer lines already run to the street, and connection costs range from $3,000 to $10,000 total depending on distance and local tap fees.
Utility Type Public Connection Cost Private System Cost Key Considerations
Water $1,500-$3,500 $5,000-$15,000 (well) Depth to water table, drilling costs
Sewer $2,000-$6,000 $3,000-$20,000 (septic) Soil percolation test required
Electricity $500-$5,000 $25-$50 per foot extension Distance from transformer
Natural Gas $1,000-$3,000 $2,500-$5,000 (propane tank) Line extension availability
Rural properties without public utilities face higher expenses. Well drilling costs $5,000 to $15,000 depending on depth and rock formations.

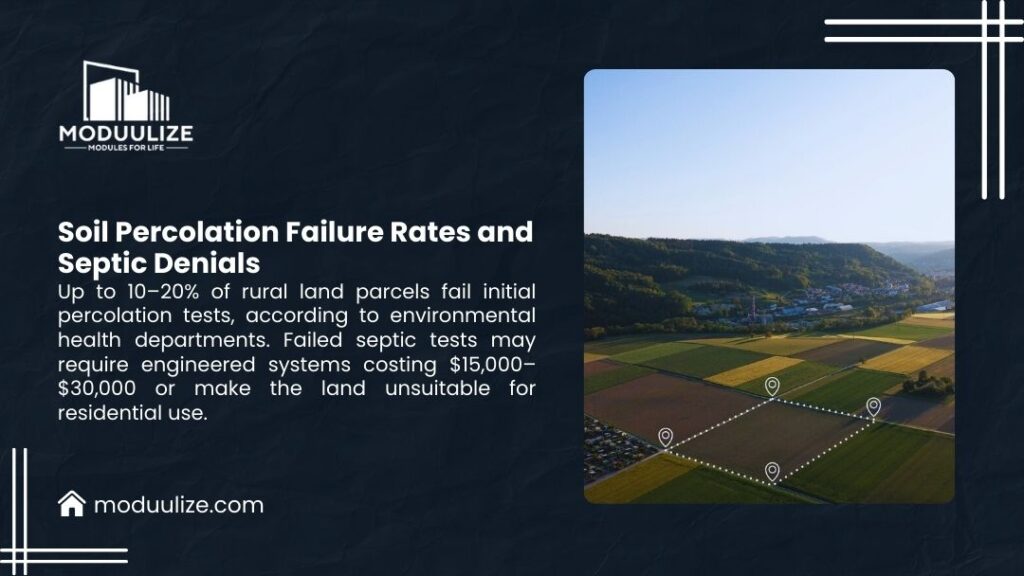

Septic systems require percolation tests at $1,000 to $3,000, plus installation at $3,000 to $20,000 based on soil conditions and system complexity.
Electric service becomes expensive when power lines sit more than 500 feet from your building site. Utility companies charge $25 to $50 per foot to extend service, which can add $12,000 to $25,000 to your project budget.
Before you buy land, contact all utility providers. Ask about connection feasibility, costs, and timeline. Some rural areas have waiting lists for new service connections that can delay construction by months.
Modular homes arrive on flatbed trucks that need clear access to your building site. Narrow roads, low bridges, sharp turns, or steep grades can block delivery entirely.
